Using Voltara Intelligence · Lesson 4 · field plant admin

Safety first: the safety pack and the gate

What has to be signed before a risky job starts and before it closes, who signs each piece, and the order that stops you getting stuck.

By the end of this lesson you can take a high-risk job from assigned to in progress and back to closed in the right order, with the right people signing, and say why the app refused if it does.

Warm-up, from memory: (1) In Lesson 2, why was Tariq's Start Work button grey? (2) In Lesson 3, which button do you press on a P1 safety alarm that needs a crew?

(1) Items in the job's safety pack were still open (shown in red), and his four pre-start confirmations were not ticked. (2) Create WO. The new job gets its safety pack, and nobody starts until it is signed.

One job carries this whole lesson: WO-2026-1013, the arc-fault trip on combiner box CB-04 (feeding inverter INV-003), raised from an alarm in Lesson 3 as an Emergency job at critical priority. After its three approvals, on 15 October 2026 it was taken through every safety step in the training copy of the app by Sara (supervisor, who raised it), Tariq (technician), Paul (plant manager), Carla (corporate) and Adam (admin). Messages in quotation marks are the app's own words.The photographs attached to the permit were labelled training images, not real site photos.

1 · The safety pack

When a job that carries risk is created, the app builds a draft safety pack for it at once: a job hazard analysis, a risk assessment, a toolbox talk and, for high-risk work, a permit to work. Nothing in the pack is finished. People have to complete and sign each piece. The safety gate checks the pack whenever someone tries to start, complete or close the job.

ItemWhoCounts as done whenWhere
JHA (job hazard analysis)Technician submits; plant, corporate or admin approvesApprovedHSE Center → JHA
Risk assessmentPlant, corporate or adminMitigated or acceptedHSE Center → JHA → risk assessments
Toolbox talkSupervisorRecorded with attendees, or a signed acknowledgementHSE Center → Toolbox
Permit to workFive people (section 3)Approved and in date to start; closed before the job can closeSafety Permits
Permit photosAnyone on the jobOne photo for each of five controlsThe permit
LOTO (if one is linked)Two people (section 4)Active to start; removed before closingLOTO register
Pre-start confirmationsThe assigned technicianAll four ticked: PPE, toolbox talk, isolation, calibrated test equipmentStart Work

For WO-2026-1013 the gate at first listed five open items, in plain words: “The job hazard analysis still needs approval; The permit to work still needs approval; The risk assessment still needs review; Hold the toolbox talk and record who attended; Pre-start verification: confirm PPE, toolbox talk, isolation and test equipment when you start the job”.

2 · Read the draft JHA before anyone approves it

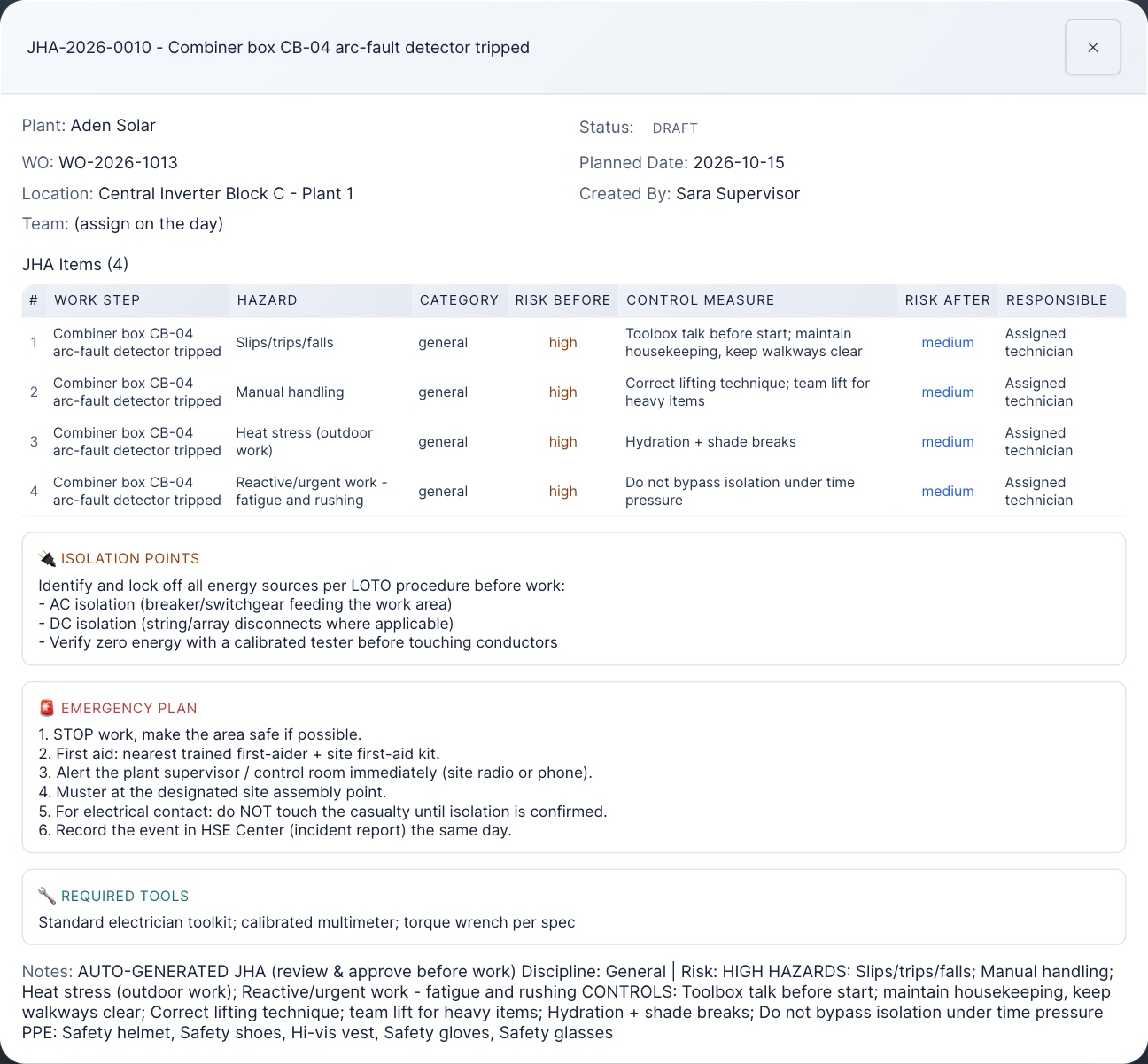

JHA-2026-0010 for WO-2026-1013, Combiner box CB-04 arc-fault detector tripped, status draft, created by Sara Supervisor. Four hazard rows, all category general: slips, trips and falls; manual handling; heat stress; reactive urgent work, fatigue and rushing. No electrical or arc-flash hazard. Notes say Discipline: General; PPE has no arc-flash protection.
The JHA the app drafted for an arc-fault trip. Four hazards, all “general”. None of them is electrical, and the PPE list has no arc-flash protection.
The draft can miss the main hazard This job is work on an inverter with up to 1,500 V DC, yet the draft lists slips, lifting, heat and fatigue, and its PPE list has no arc-flash protection. The hazard rows of a drafted JHA cannot be edited in the HSE Center today, and a plant-level user can approve it straight from draft, including the person who raised the job. Until this is fixed: This has been reported as a fault.

On WO-2026-1013, Tariq submitted the JHA and Paul approved it. When Tariq tried to approve it himself, the app refused: approving is plant level and above.

3 · The permit to work: five people

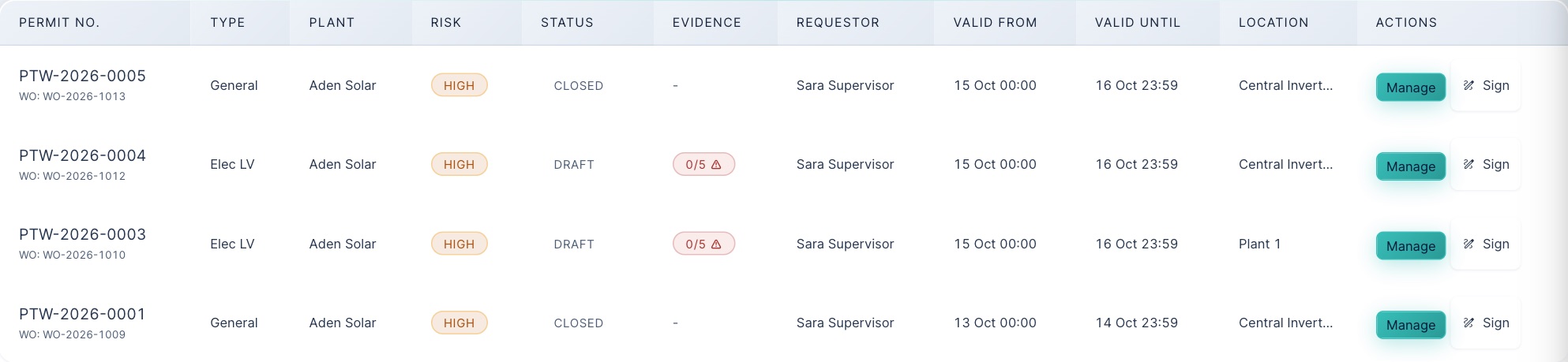

Safety Permits register: PTW-2026-0005 for WO-2026-1013 closed; PTW-2026-0004 for WO-2026-1012 and PTW-2026-0003 for WO-2026-1010 in draft with evidence 0 of 5; PTW-2026-0001 closed. Each row shows type, plant, risk high, requestor Sara Supervisor, valid from and until, location, and Manage and Sign buttons.
Safety Permits, as Tariq saw it. A drafted permit shows 0/5 under Evidence until its five photos are attached. Note PTW-2026-0003: its job was cancelled, but the permit was left in draft. Sign offers only the slots you may sign.

A permit goes draft → signed → approved → active → closed, and it needs five different people:

Role on the permitWho may hold itOn WO-2026-1013
RequestorWhoever raised itSara
HSE signaturePlant, corporate or adminCarla
Area owner signaturePlant or adminPaul
Supervisor signaturePlant, site or adminTariq
ApproverPlant, corporate or admin, and none of the four aboveAdam

When Sara tried to sign as supervisor: “The permit requestor cannot also sign as HSE, Area Owner or Supervisor (separation of duties).” When Paul, who had signed as area owner, tried to approve (after the photos were on; before that the photo refusal comes first): “the approver must be someone other than the requestor and the three people who signed it … 3 other authorised approvers are available on this plant - ask one of them to approve it.” At a small plant where every supervisor has already signed, a corporate or fleet approver can approve.

What approval and activation need

  1. To approve: the three signatures; the approver's four ticks (JHA complete, isolation plan adequate, team competent, PPE available); and photos of the signed JSA, HIRA (hazard and risk sheet) and toolbox talk sheet. Without the photos: “PERMIT REFUSED - photo evidence missing … JSA; HIRA; TBT”.
  2. To activate (the moment work is authorised): the JHA approved; two more photos, of the locks and tags in place and the tools and test equipment; and, for high-risk permits, the activation checks (JSA reviewed, PPE, LOTO, certificates). The person activating ticks these on the Safety Permits screen at that moment; ticking only JSA: “Not confirmed: arc flash PPE verified, LOTO applied, certifications verified.” With all ticked: “Permit PTW-2026-0005 is active. Work may start.” A permit with no end time cannot be activated.
  3. Each photo must be different. Reusing the JSA photo as the LOTO photo: “That is the same photograph already attached as JSA evidence on this permit. Each hazard category needs its own photograph of that control.”
  4. Mind the dates. A permit is only good between its valid from and valid until. Once it expires the gate says “The permit ran out on …” and the job cannot restart until the permit is extended or a new one is raised. Extending needs a reason and a new end time later than the current one.

4 · LOTO: two people, every time

Lockout tagout is recorded in the LOTO register, linked to the job. The rule is that one person never isolates, proves and releases on their own:

  1. Fit the locks and record each isolation point with its lock and tag numbers, and who fitted them. Sara filed LOTO-2026-0102 (CB-04 DC isolator, INV-003 DC input 2) and named Tariq as the fitter. Status: pending verification. Both the person who files the form and the person who fits the lock count as “the installer” from now on.
  2. A third person proves zero energy, with a test reading for every point. Tariq: “You fitted this lock, so a second person must verify zero energy (two-person rule).” Sara, who filed it: “Zero-energy verification must be performed by a different person from the lock installer.” Paul with one reading blank: “All isolation points must be confirmed with a test reading”. Paul with both readings: “LOTO-2026-0102 is now ACTIVE (2 points confirmed)”.
  3. At the end, someone else removes the locks, with a verifier who is neither the fitter nor the filer. Tariq: “you fitted this lock, so you cannot remove it yourself. A colleague at this plant must remove it, or a plant manager can clear it by emergency removal.” Paul removed them with Carla as verifier. In a genuine emergency a plant manager of that plant, or a corporate or admin user, can authorise an emergency removal; corporate and admin are told at once.

5 · Start, finish and close, in this order

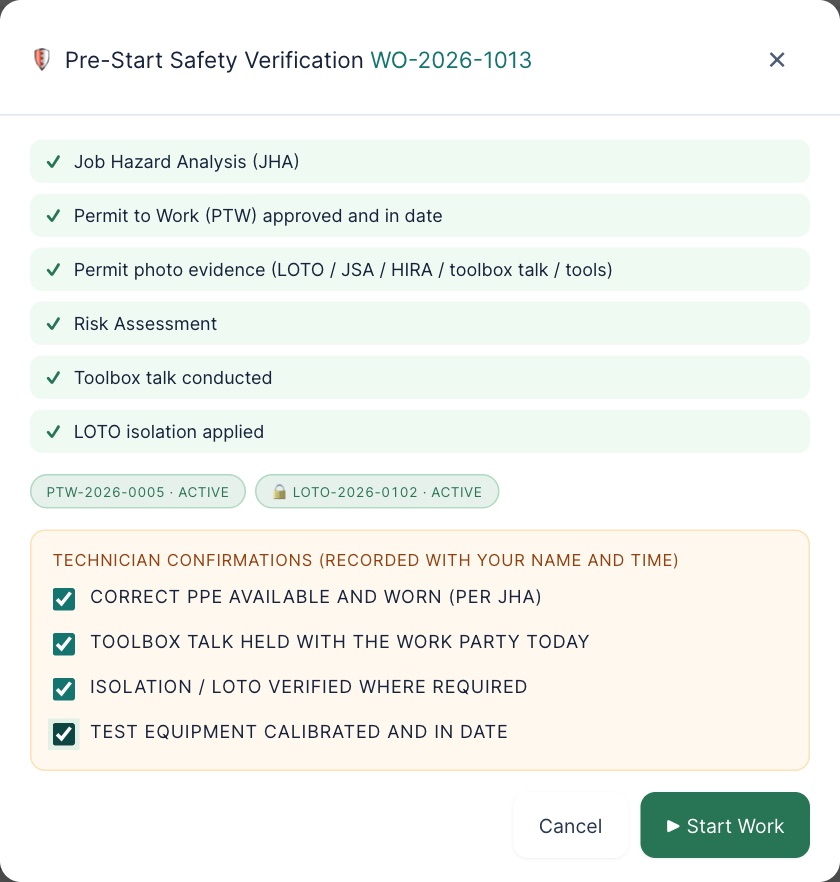

Pre-Start Safety Verification for WO-2026-1013: six green ticks (JHA, permit approved and in date, permit photo evidence, risk assessment, toolbox talk, LOTO isolation applied), PTW-2026-0005 active, LOTO-2026-0102 active, and the four technician confirmations ticked above a green Start Work button.
Everything signed, and Tariq's four confirmations ticked (recorded with his name and the time). Start Work turns green.

After the work, the order matters, because each step is refused until the one before it is done:

  1. Complete (technician): every checklist step answered, then the four completion statements and notes. Corrective jobs also need downtime hours (“Enter 0 if the fault caused no production loss”).
  2. Verify (plant level): corrective jobs need a failure code, a cause code and a remedy code.
  3. Remove the locks (a second person). A permit cannot close while they are on: “Cannot close permit - LOTO is still active. Remove all isolations first.”
  4. Close the permit, with closure notes (“Closure notes are required”).
  5. Close the work order. Trying it with the permit and locks still live: “Close the permit before closing the job; Remove the locks and close the isolation before closing the job.”
Tick only what is true One completion statement reads “All LOTO isolations verified removed / or not applicable”. Tariq ticked it while his locks were still on, and the app accepted it. The app only checks the locks at closing. The statement is your word, recorded with your name.

6 · The emergency override

There is an emergency override, built so it cannot happen quietly. A corporate or admin user can let one step (start, complete or close) through a blocked gate, from the Authorise emergency override button in the work order's detail. The rules, all tested:

It is for a real emergency (a fire pump at 3 a.m.), not for a permit nobody has got round to signing.

Fill in the checklist before you use an override to complete The override is used up the moment the safety gate would have blocked, even if a later check then refuses the step. We completed a job under a completion override with its checklist blank: the checklist refused (“6 of 6 steps not recorded”), the job stayed in progress, and the override was gone. A second override had to be granted. This has been reported as a fault.

7 · Practice

Allowed or refused?

All ten were tried in the training copy.

Put the permit's life in order

Put the end of the job in order

From memory: (1) Name the five people a permit needs, and the one rule about who may approve. (2) Which two photos are added just before activation, and why not earlier? (3) The drafted JHA for an electrical job lists only slips and heat stress. What do you do?

(1) Requestor, HSE signatory, area owner, supervisor and approver; the approver is none of the other four. (2) The locks and tags in place, and the tools and test equipment: they only exist on site, just before the work is released. (3) Do not submit or approve it as it is. Tell your supervisor and HSE officer, and write the missing hazards and controls on the signed JSA sheet you photograph for the permit.

Your part, by role

You areYou do
field TechnicianRead and submit the JHA. Sign the permit's supervisor slot if asked (not your own permit). Take the five photos. Fit locks; never prove or remove your own. Tick the pre-start and completion statements only when true.
plant Supervisor, plant manager, HSEApprove JHAs that cover the real hazard. Mitigate risk assessments. Record toolbox talks with attendees. Sign permit slots; approve permits you did not sign. Prove zero energy and remove locks as the second person.
corporateSign the HSE slot or approve permits where a plant has no free approver. Grant an emergency override only for a real emergency.
adminAny slot or approval except where you already signed. Emergency overrides, with the same care.
Do next (15 minutes), in the app Open Safety Center → Safety Permits at your plant. Pick one live permit and check: who holds each of the five roles, whether its five photos are all different, and when it runs out. Then open the LOTO register and, for one active lock, name its fitter and the person who proved zero energy. (The printed User Guide chapters 15 and 16 wrongly say there is no override.)
Questions? Ask me in the chat, for example “what goes in a HIRA?” or “how do I extend a permit?”. Then try it: open Safety Permits for your plant, pick one live permit, and say which of the five people signed it and whether its five photos are all different.

Reference: Safety card · Glossary · Previous: Lesson 3 · Next: Lesson 5, Field work on the phone
